UNITECHHydropower

About Us

Welcome to Unitech Hydropower Company Limited

Unitech Hydropower — corporate and project context

About us

Company at a glance

The Company was established on 2071/06/20 under the Companies Act of Nepal. Initially, the company was registered as a Private Limited and then converted public limited on 2079/10/19 to facilitate business growth and attract public investment. The office is located at Lalitpur-01, Kupondole, Lalitpur Metropolitan City, Lalitpur district.

Projects · Contact

Established (BS)

2071/06/20

Public Ltd (BS)

2079/10/19

Office

Lalitpur-01, Kupondole

Lalitpur Metropolitan City, Lalitpur

Corporate history

Major dates of the company

Key registrations and operational milestones in Bikram Sambat (BS)—the journey from incorporation to commercial power generation.

2071/06/10 BS

Initial company registration (Private Limited)

2074/11/11 BS

PPA (Power Purchase Agreement)

Secured agreement for the sale of 33.05 GWh of annual energy, ensuring long-term revenue stability.

2075/01/05 BS

Initial industry registration

Registration no. 5120

2075/05/19 BS

Generation licence

2079/10/06 BS

Converted to Public Limited

Transitioned corporate structure to facilitate business growth, transparency, and attract broader public investment.

2081/01/08 BS

Commercial Operation Date (COD)

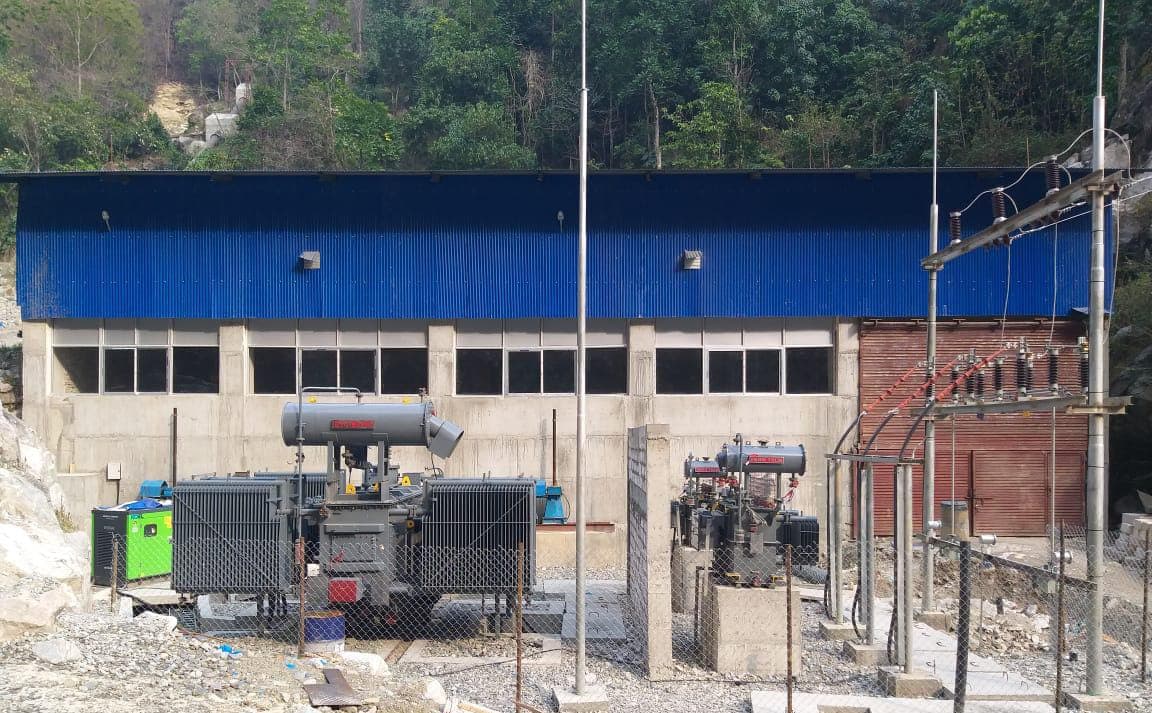

Successfully commenced commercial power generation of 5.8 MW, overcoming significant global and logistical challenges.

2082/03/29 BS

Industry registration (Public Limited)

Registration no. 5120

About Us

Clean Energy for Nepal's Future.

Leadership

Chairman’s message

A message from Anoj Khadka, Chairman

It gives me great pleasure to welcome you to Unitech Hydropower Company Limited.

Since our establishment, we have remained committed to contributing to Nepal’s growing energy needs through the sustainable development of hydropower resources. Our transition from a Private Limited Company to a Public Limited Company reflects our dedication to growth, transparency, and broader stakeholder participation.

Nepal’s hydropower sector holds immense potential, and we believe that its responsible development is key to long-term national progress. At Unitech Hydropower, we are focused on delivering efficient, environmentally responsible, and economically viable energy projects that create sustainable value for all stakeholders.

During the project development phase, the Company faced several significant challenges that impacted construction progress and project cost. The COVID-19 pandemic resulted in major disruptions, including nearly one year of inactivity during the first lockdown. As the lockdown was lifted during the rainy season, immediate remobilization of works was not feasible, leading to further delays. The second lockdown also hindered critical activities such as headworks construction and pipeline excavation.

Operational and logistical constraints further affected progress, including the provision of support to local administrative offices during the pandemic and detention of electro-mechanical equipment at the border, resulting in additional charges. The project also experienced financial pressure due to delays in mobilization of committed equity, along with a sharp increase in fuel prices, which significantly impacted construction and transportation costs.

In addition, approval for army mobilization was delayed due to requirements for on-site barracks and bunkers, leading to additional costs beyond initial project estimates. After several rounds of coordination, approval was obtained to utilize the Taplejung Barrack for deployment, enabling further progress of the project. Overall, these combined factors resulted in a time lapse of approximately 20 months from the initial mobilization of the civil contractor, leading to both schedule delays and increased project costs.

Despite these challenges, our commitment to delivering reliable and sustainable hydropower solutions remains unwavering. We continue to strengthen our project management practices and coordination efforts to overcome obstacles and ensure successful project completion.

We are guided by strong principles of integrity, accountability, and innovation. With the continued support of our investors, partners, and dedicated team, we are confident in achieving our goals and contributing meaningfully to Nepal’s energy sector.

I would like to express my sincere gratitude to all our stakeholders for their trust and support. We look forward to achieving new milestones together.

Thank you.

Capital structure

Investment profile

Amounts in NPR crore unless stated.

Authorized Capital

120 cr.

Total capital authorized for issuance.

Issued Capital

98.50 cr.

Capital currently issued to shareholders.

Paid Up

78.80 cr.

66% of authorized capital deployed.

IPO

19.7 cr.

Rating: ICRA Nepal | Manager: LS Capital

Governance

Board of Directors (BOD)

Anoj Khadka, Chairman

Anoj Khadka

Chairman

Dinesh Lal Shrestha, Director

Dinesh Lal Shrestha

Director

Anand Kumar Basnet

Director

Shobha Basnet, Director

Shobha Basnet

Director

Vishwa Prakash Amatya, Director

Vishwa Prakash Amatya

Director

Pramod Kumar Shah

Independent Director

Operations

Management team

Bhaskar Kafle, CEO

Bhaskar Kafle

CEO

Rabindra Mahaseth, Project Co-ordinator

Rabindra Mahaseth

Project Co-ordinator

Shrina Ghimire, Account / Admin Officer

Shrina Ghimire

Account / Admin Officer
